P6 Schedule Analytics
Schedule analysis

Know if your P6 programme will stand up to scrutiny, in minutes.

Upload an XER or P6 XML export. Get the DCMA 14-point assessment, earned value and earned schedule, a critical path recomputed from the logic, and every defect with the activities behind it.

  • Reads XER and P6 XML
  • No P6 licence needed
  • Hosted in the EU (Frankfurt)
NAR-132-RC Rev 6 · data date 30 Jun 2026

Schedule Health

57%

8 of 14
checks pass

  1. 01LogicPass
  2. 02LeadsFail
  3. 03LagsPass
  4. 04Relationship typesPass
  5. 05Hard constraintsPass
  6. 06High floatPass
  7. 07Negative floatFail
  8. 08High durationPass
  9. 09Invalid datesPass
  10. 10ResourcesFail
  11. 11Missed activitiesFail
  12. 12Critical path testPass
  13. 13CPLIFail
  14. 14BEIFail
Fictional 132 kV overhead line programme · real engine output

Built by a planner for programmes in Rail, Energy and overhead lines, Offshore, Buildings and Civils.

  • DCMA 14-point
  • EVM and Earned Schedule
  • NEC4 clauses 31 and 32
  • Monte Carlo QSRA
  • [CLIENT LOGO]
  • [CLIENT LOGO]
  • [CLIENT LOGO]
  • [CLIENT LOGO]
  • [CLIENT LOGO]
  • [CLIENT LOGO]
Why it exists

Programme review is still done by hand. It shouldn't be.

A programme gets scrutinised by the client, the Project Manager and, if it goes wrong, a delay expert. This checks it the way they will, first.

  1. Problem 1

    Every period, the same checks rebuilt in Excel.

    Open ends, leads, lags and hard constraints counted by hand, and counted differently each time.

    Answer

    Fourteen DCMA checks and 25 diagnostic checks on upload.

    Each result opens to the activities behind it, with a CSV of the full list. The same rules every period.

  2. Problem 2

    Programmes rejected late.

    A missing access date or no time risk allowance, found by the Project Manager after submission.

    Answer

    NEC4 clause 31 and 32 checks before you submit.

    Each item passes, fails, or is marked to check by hand with what to look for, so nothing is silently passed.

  3. Problem 3

    A critical path nobody can defend.

    Stored float from a file that wasn't rescheduled, so half the job reads critical.

    Answer

    A critical path recomputed from the logic.

    Each activity on its own calendar, each lag on its predecessor's, and a warning when the stored dates are stale.

The product

One upload. Twelve ways to read it.

Every module runs on the same export, and every figure below is the real result on our fictional 132 kV overhead line programme at its sixth update.

How it works

From export to assessment in three steps.

Measured on a 2,786-activity, 34 MB export: parsed in 4–6 seconds, the full report in under a second more.

  1. Step 1

    Export from P6

    File → Export in P6, as XER or P6 XML. Schedule (F9) first so the dates and float are current.

    How to export a clean XER →
  2. Step 2

    Upload

    Drop the file in. Load earlier updates or a baseline alongside it to unlock trend and delay analysis.

  3. Step 3

    Read the assessment

    Schedule Health, the dashboard, the Gantt and every other module, from the same upload. Export what you need.

Schedule Health

Fourteen checks, and the activities behind every one.

The 14 DCMA checks, counted the way DCMA counts them: checks 1–10 on incomplete work, and relationships only where the successor is still open. Each check shows its threshold, its result, a gauge against the limit and the activities behind it.

  • Every failed check opens to the activities that failed it, with a CSV of the full list.
  • Counted on incomplete work by default, so finished history doesn't flatter or punish the plan that's left.
  • Thresholds, the hard-constraint list and which checks count towards the score are all adjustable.

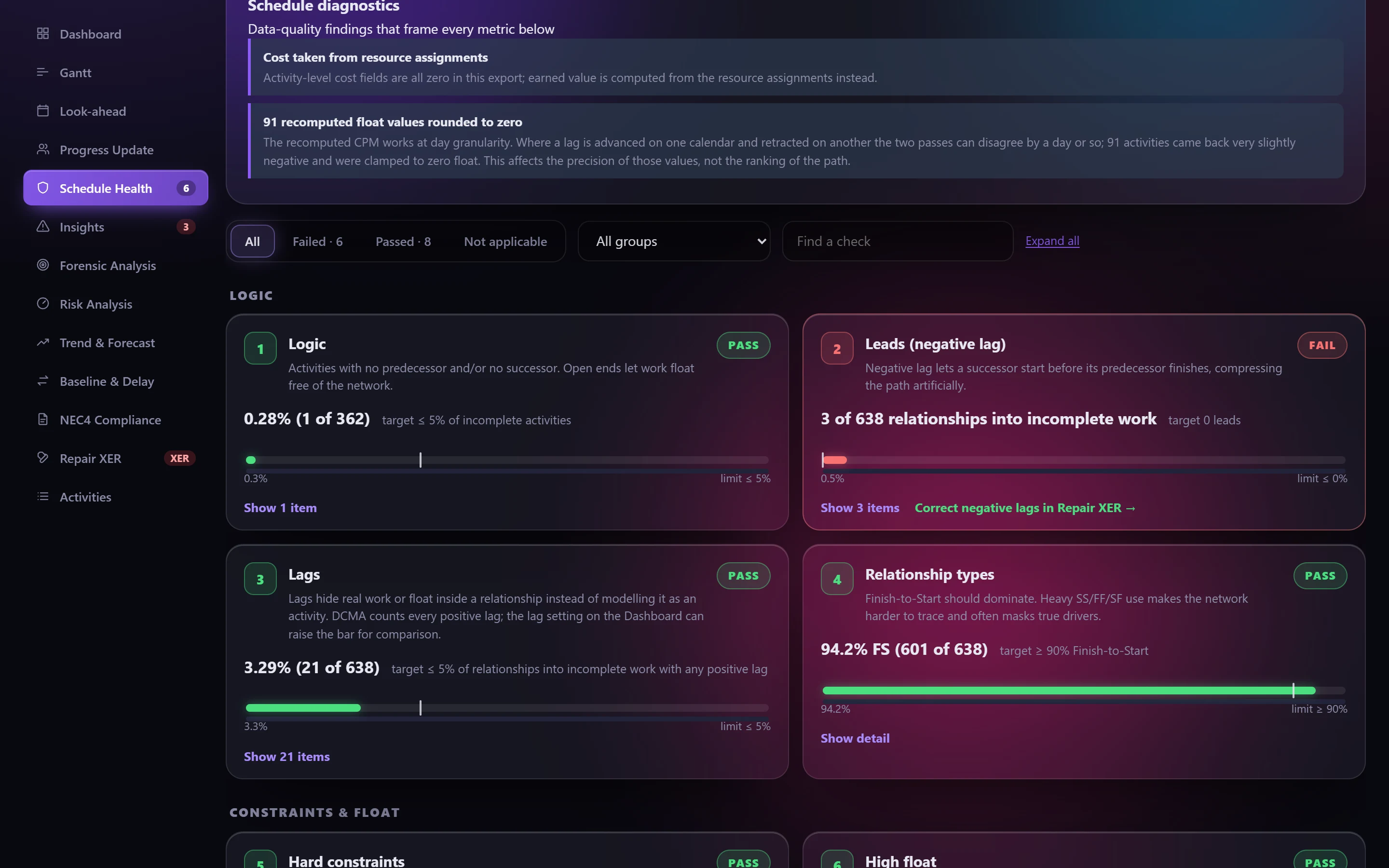

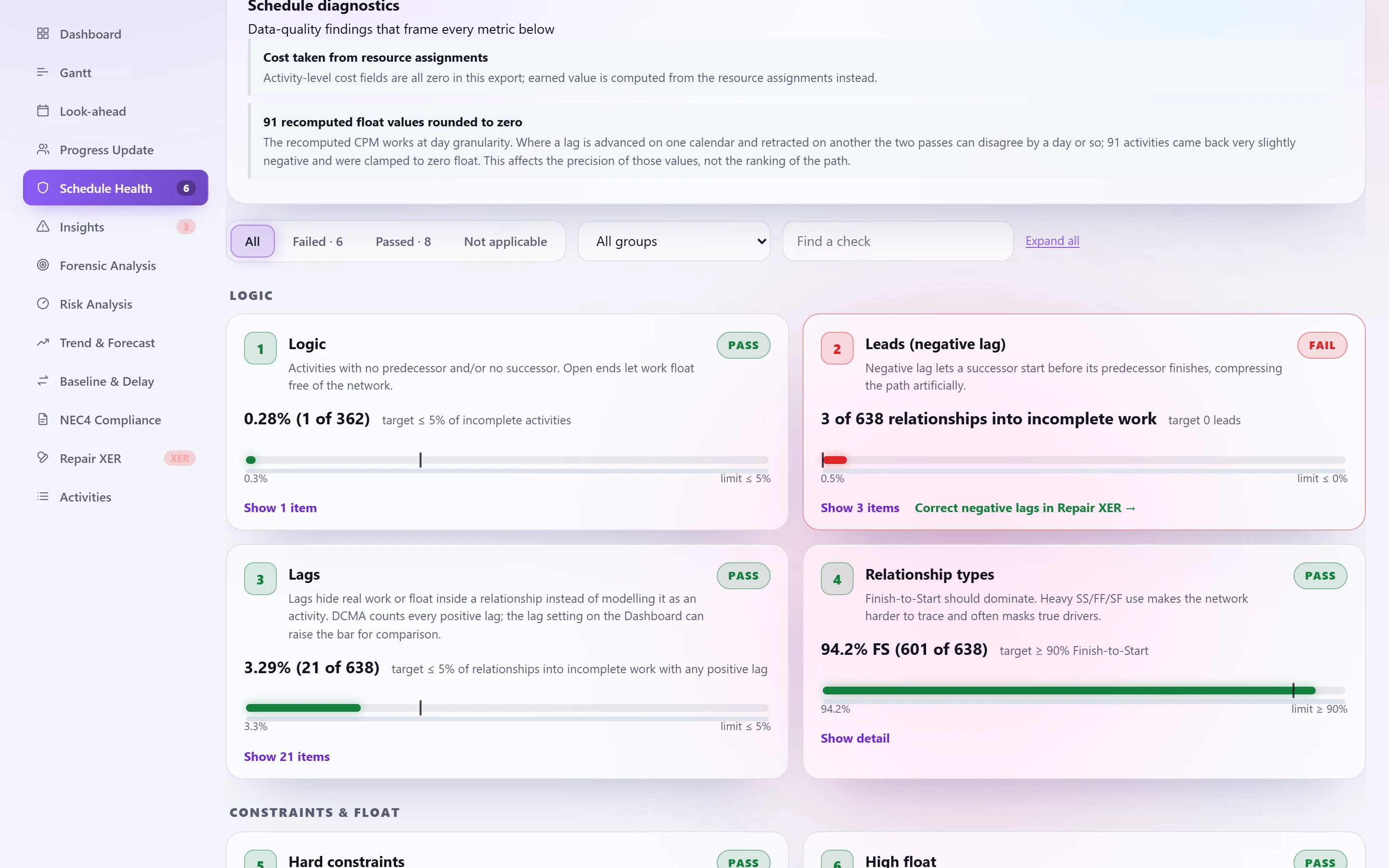

The 14 DCMA checks, each with its result, threshold and gauge.
Schedule Health · demo programme Rev 6
Forensic analysis

From what's wrong to what to change in P6.

A deeper pass, organised the way a forensic delay analyst reports: an executive scorecard with claims vulnerability, the critical path and float diagnostics, an anomaly register, root causes and a remediation plan down to P6's scheduling options.

  • Acumen-style metrics against stated thresholds, including logic density, hotspots and dangling logic.
  • With two updates, half-step attribution splits the finish movement into progress and revisions.
  • Liability is only ever a suggestion until a person assigns it, and the assignment is saved.

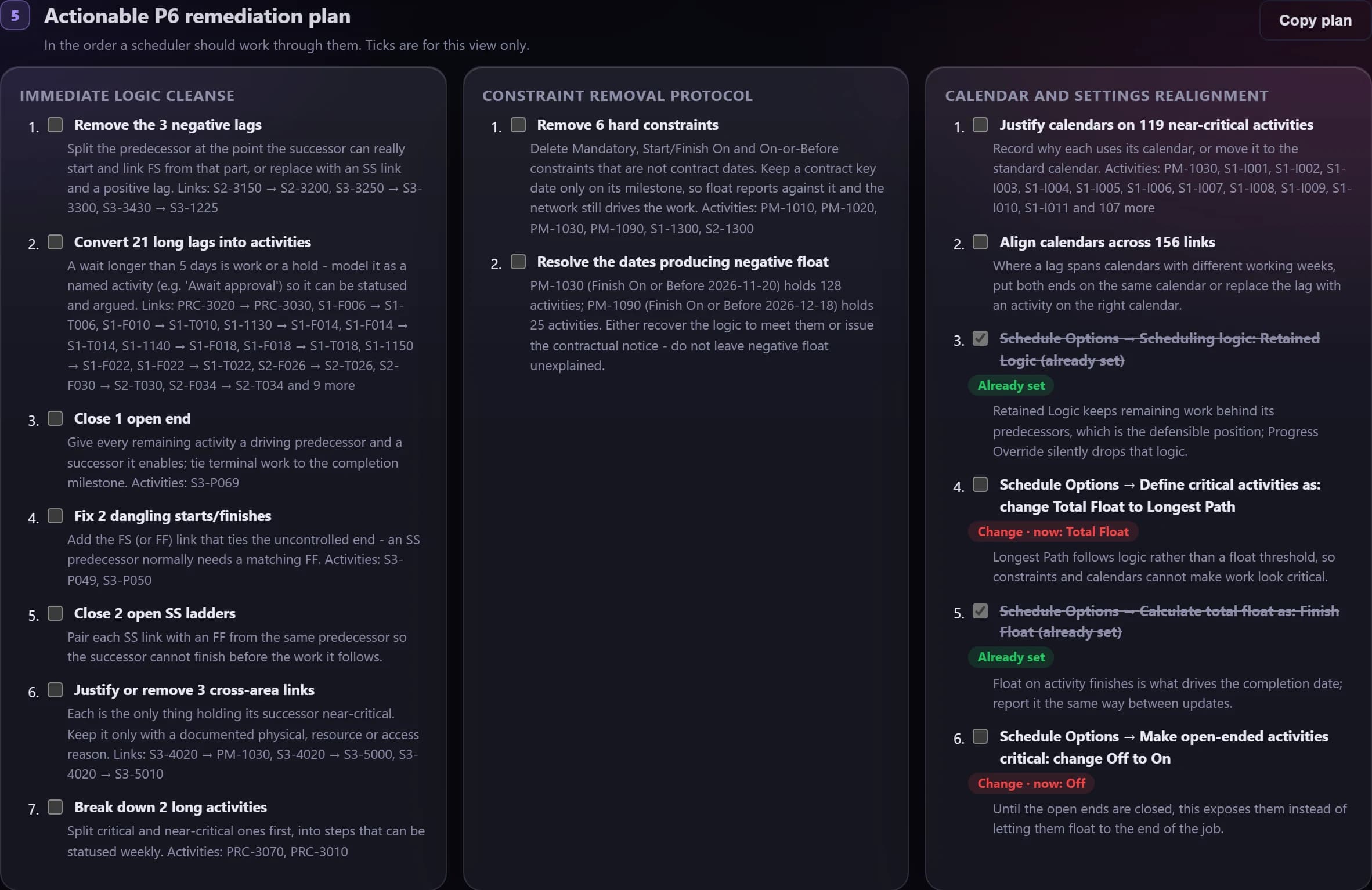

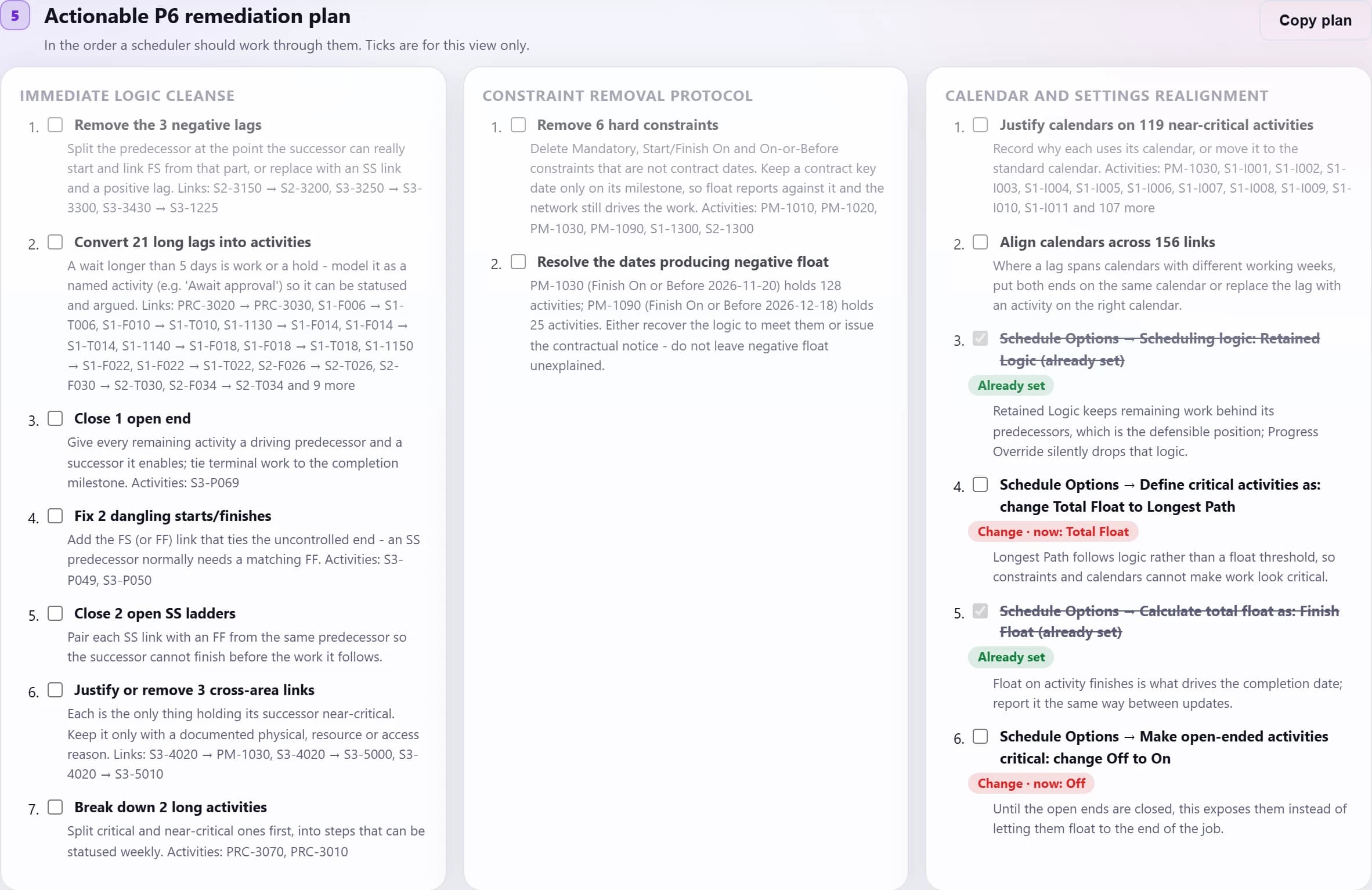

Forensic remediation plan: the links, constraints and P6 schedule options to change, each with its reason.
Forensic remediation plan · demo programme Rev 6
NEC4 programme checks

Know what the Project Manager will see before you submit.

The programme assessed against what NEC4 ECC clause 31.2 requires it to show, the grounds for non-acceptance in 31.3, and the revised-programme requirements of 32.1 and 32.2. Each item passes, fails, doesn't apply, or is marked to check by hand with what to look for.

  • Planned Completion against the Completion Date, and terminal float, in working days.
  • Judged on the programme as it stands now: work under way counts at its forecast finish.
  • What a programme file can't evidence is never silently passed. It's listed with what to check.

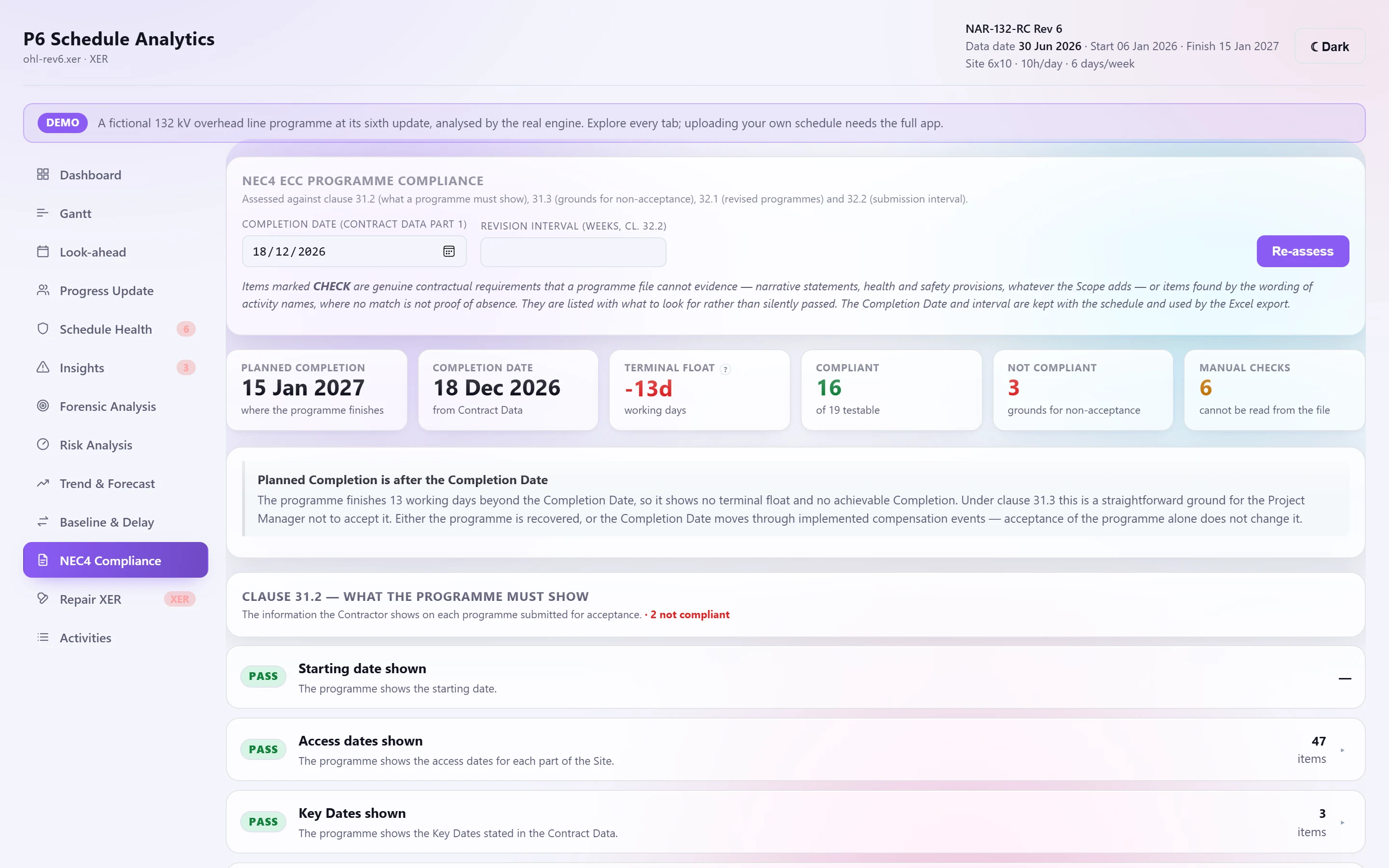

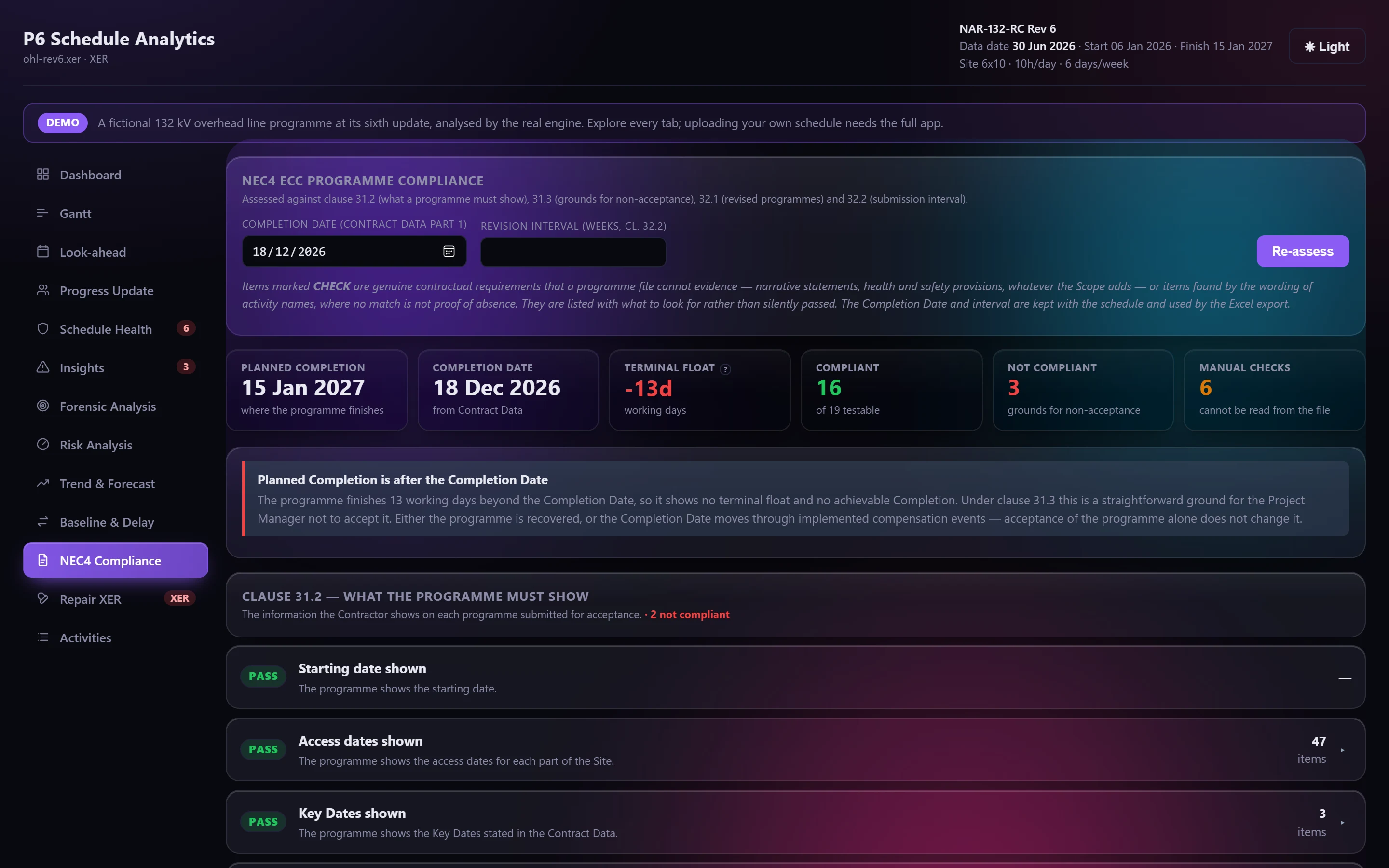

NEC4 compliance: clause 31 and 32 items marked pass, fail or check by hand.
NEC4 compliance · demo programme Rev 6
Who it's for

Four jobs, one set of evidence.

More for planners →
Security

Your programme is commercially sensitive. We treat it that way.

A programme shows how a contractor plans to win or defend money. It's handled accordingly.

  • Encrypted in transit

    Every request to the hosted service travels over HTTPS.

  • Hosted in the EU (Frankfurt)

    Your programmes are processed and stored in the EU.

  • Only the people you allow

    Roles and activity-level access, enforced on the server, not just hidden in the page.

  • Or keep it in-house

    Enterprise customers can run a dedicated instance, or install it on their own servers.

How uploads are handled →
Pricing

Priced per planner, not per project.

Start with a free 14-day trial. Or review a single programme with a 90-day project pass for £149.

Professional

Planners and consultants

£32.50per user / month

£390 per user, billed annually

Start 14-day trial
Most teams choose

Team

Project controls teams

£99per user / month

£1,188 per user, billed annually · minimum 3 seats

Start 14-day trial

Enterprise

Tier 1 contractors, clients and PMOs

Custom

Quoted for your seats and hosting

Talk to us

Founding customers: the first 50 subscribers keep 30% off for as long as they subscribe.Compare every plan →

Questions

Asked by planners, answered plainly.

Check your next update before anyone else does.

Fourteen days free. Export an XER from P6 and see what it says.
